BARDA

Humphreys and Assoc Reviews 7 Principles of Earned Value Management Tier 2 System Implementation Intent Guide

, , , , , , ,

In this video we review the 7 Principles of Earned Value Management Tier 2 System Implementation Intent Guide published by the Assistant Secretary for Preparedness and Response, or ASPR.

This Guide is primarily used by the Biomedical Advanced Research and Development Authority, or BARDA, on countermeasure R&D contracts that have a total acquisition cost greater than $25 million and a Technical Readiness Level of less than 7.

7 Principles of Earned Value Management Tier 2 System Implementation Intent Guide -- EVM Cross Reference Guide

Humphreys and Assoc Reviews 7 Principles of Earned Value Management Tier 2 System Implementation Intent Guide Read Post »

7 Principles of Earned Value Management Tier 2 System Implementation | EVM Analysis

, , ,

Updated: Watch our review video of 7 Principles of Earned Value Management Tier 2 System Implementation Intent Guide



7 Principles of Earned Value Management Intent GuideThe Assistant Secretary for Preparedness and Response (ASPR) issued the “7 Principles of Earned Value Management Tier 2 System Implementation Intent Guide,” 21 December 2011.  Since most of BARDA acquisitions are unique in that they are not Information Technology (IT) projects or Construction projects, they developed a tiered approach to applying EVMS. Tier 1 are construction and IT contracts and will require full ANSI/EIA-748 compliance. Tier 2 contracts are defined as countermeasure research and development contracts that have a total acquisition cost greater than $25 million and have a Technical Readiness Level of less than 7. Tier 2 contracts will apply EVM principles that comply with the 7 Principles of EVM Implementation. Tier 3 are countermeasure research and development contracts between $10 million and $25 million and will require EVM implementation that is consistent with the 7 Principles approach. The focus of this implementation guide is on the Tier 2 contracts.

The Intent Guide contains explanations for each Principle, a Glossary of Terms, a Supplemental EVM Implementation Guideline, and Sample EVM Documents. The Supplemental EVM Implementation Guideline contains recommendations regarding EVM process flows, tools, the necessity to integrate the EVM engine with the accounting system, basic documentation requirements, ranges of implementation costs, recommendations on requirements for support personnel, and use of the 7 Principles on Tier 3 programs.

The Intent Guide defines Tier 2 as: “For countermeasure research and development contracts that have total acquisition costs greater than or equal to $25 million and have a Technical Readiness Level (TRL) of less than 7 will apply EVM principles for tracking cost, schedule and technical performance that comply with the 7 Principles of EVM Implementation.”

The 7 Principles of Earned Value Management

1. Plan all work scope to completion.

This Principle includes development of a Work Breakdown Structure (WBS) and WBS Dictionary that includes all of the work scope.  It is also recommended that detailed scope definition be accomplished at the work package level.

2. Break down the program work scope into finite pieces that can be assigned to a responsible person or organization for control of technical, schedule and cost objectives.

This Principle defines the schedule requirements.  Most scheduling functions are required including network scheduling, horizontal and vertical traceability, forecasting schedule start and complete dates, and critical path analysis.  The contract milestones must also be included in the schedule.

This Principle also discusses the organizational requirements.  The Control Account Manager must be identified but there is no requirement for the costs to roll up through organizational elements; this, and development of an Organization Breakdown Structure (OBS) is recommended if it can be done in a cost effective manner.

3. Integrate program work scope, schedule, and cost objectives into a performance measurement baseline plan against which accomplishments can be measured. Control changes to the baseline.

This Principle is discussed in the Intent Guide in two parts.  The first, 3a, regards integration of scope, schedule, and cost objectives into a performance measurement baseline. The schedule can be either resource loaded or the budgets loaded into a cost tool and a time-phased control account plan generated.  The cost tool must be linked to the schedule tool to ensure baseline integration.  The planning includes both direct and indirect dollars.

This Principle also defines the use of undistributed budget and management reserve.

The second part of this Principle, 3b, is the requirement to control changes to the baseline. This requires that contractual changes be incorporated to the baseline in a timely manner.

Budget logs are to be used to track both external and internal changes. All changes are to have documentation that explains the rational/justification for the change and the scope, schedule and budget for that change.

4. Use actual costs incurred and recorded in accomplishing the work performed.

This Principle requires that actual costs be accumulated in a formal accounting system consistent with the way the work was planned and budgeted.  A work order or job order coding system must be used to identify costs to the control account and allow summarization through higher levels of the Work Breakdown Structure.  The use of estimated actuals is also required for material and subcontractors to ensure that earned value data is not skewed.

5. Objectively assess accomplishments at the work performance level.

This Principle requires that schedule status and earned value assessment must occur at least monthly.  The allowable earned value techniques are discussed as well as the requirements of for the use of each.

6. Analyze significant variances from the plan, forecast impacts, and prepare an estimate at completion based on performance to date and work to be performed.

This principle is also divided into two parts.  The first, 6a, regards the analysis of variances from the plan.  The earned value system must be able to calculate cost and schedule variances, at least cumulatively, on a monthly basis.  The system should also be able to provide the Cost Performance Index (CPI), the Schedule Performance Index (SPI), and the use of the To-Complete Performance Index (TCPI) is also encouraged.  Variances that exceed the contract variance thresholds must be explained in terms of the cause, impact and corrective action.  Although this Principle does not discuss the preparation of a Variance Analysis Report (<abbr=”Variance Analysis Report”>VAR) by the CAM, Principle 7 does require that Program Managers hold their CAMs accountable to write a proper Variance Analysis Report (Earned Value Management Analysis).

The second part of this Principle, 6b, requires that an Estimate at Completion (EAC) be prepared based on performance to date and the work remaining to be performed.

7. Use earned value information in the company’s management processes.

This Principle regards Program Management use of the earned value data to manage the program’s technical, schedule and cost issues and how that data is used in the decision making process.

Although much of the language in the Intent Guide is similar to that of typical guidance documents for the EVMS requirements, it must be remembered that the EVMS Guidelines are not being implemented, only the 7 Principles.  The Principles define an approach to managing programs with the basic requirements of Earned Value; such that the cost of the system is minimized, but only those elements necessary to manage these types of programs are necessary.  This allows for further system flexibility and reduces the documentation needed.  For instance, in Principle 1, the requirements of the WBS Dictionary could be expanded to contain the information that would normally be included on the Work Authorization Document.  If this were done, Work Authorization Documents are not necessary because the WAD content normally contained would be embodied in the WBS dictionary; and the associated cost is reduced over the life of the program.

With the 7 Principles there is no need for an EVM compliance review.  An Integrated Baseline Review (IBR), also known as a Performance Measurement Baseline Review (PMBR), could be required.

The 7 Principles Comparison to the EIA-748 32 Guidelines

For those who are more accustomed to the EVMS Guidelines as described in the EIA Standard, EIA-748, in the table below the 7 Principles are loosely identified to the 32 Guidelines and Guideline areas.  This does not mean that all of the requirements must be met with the 7 Principles only that they can be cross-referenced.  Several of the Guidelines are not specifically identified but could be considered as incorporated by reference. The indirect cost requirements are incorporated by planning the work with both direct and indirect dollars; therefore, it is implied that budget, earned value, and actual costs would also include both direct and indirect costs.

The appendix also contains the requirement that the EVM Engine needs to be integrated with the company’s accounting system.  Further, some programs may also be required to be compliant with the Cost Accounting Standards.  Guideline 20, “Identify unit costs, equivalent units costs, or lot costs when needed” is not included; this more than likely would not be a requirement for HHS or BARDA programs.

Earned Value Analysis: 7 Principles of EVM Tier 2 System Implementation Cross-Reference to the EVMS Guidelines

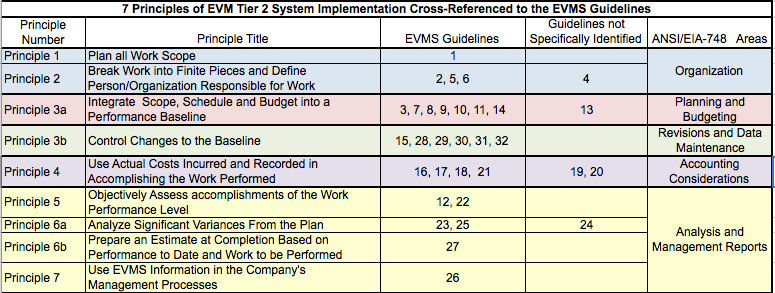

7 Principles of EVM Tier 2 System Implementation Cross-Reference to the EVMS Guidelines
Principle Number Principle Title EVMS Guidelines Guidelines not Specifically Indentified ANSI/EIA-748 Areas
Principle 1 Plan all Work Scope 1 Organization
Principle 2 Break Work into Finite Pieces and Define Person/Organization Responsible for Work 2, 5, 6 4
Principle 3a
Integrate Scope, Schedule and Budget into a Performance Baseline 3, 7, 8, 9, 10, 11, 14 13 Planning & Budgeting
Principle 3b
Control Changes to the Baseline 15, 28, 29, 30, 31, 32 Revision & Data Maintenance
Principle 4 Use Actual Costs Incurred and Recorded in Accomplishing the Work Performed 16, 17, 18, 21 19, 20 Accounting Considerations
Principle 5 Objectively Assess Accomplishments of the Work Performance “Level 12, 22 EVM Analysis & Management Reports
Principle 6a
Analyze Significant Variances fomr the Plan 23, 25 24
Principle 6b
Prepare and Estimate at Completion based on Performance to-data and Workd to be Performed 27
Principle 7 Use EVM information in the Company’s Management Processes 26

Recommendations for Enhancement to the Intent Guide

The 7 Principles Intent Guide was issued in December 2011. In June 2012 the requirements for the Integrated Program Management Report (IPMR) was issued; this will replace the Contract Performance Report (CPR) for contracts issued after June 2012. When a revision to the Intent Guide is issued, the IPMR should be included.

The Intent Guide is a “what to do” document and contains little on “how to do it”. Internal procedural documents should be required to define how a company will implement the Guide requirements.

Principle 6a requires that the cost and schedule variances be calculated at least on a cumulative basis and only recommends calculation of the current month. The current month calculation should be a requirement since both the CPR and the IPMR require current month reporting.

Summary

The “7 Principles of Tier 2 System Implementation Intent Guide” requires the basic elements of earned value and the documentation necessary to demonstrate that earned value is being adequately implemented on Tier 2 programs. H&A personnel understand the requirements and are able to “size” those requirements to meet company and customer needs. Click to request a PDF copy of the Intent Guide.

Humphreys & Associates (H&A) has been providing Earned Value Management training and implementation services for over 35 years. H&A provides self-paced online, classroom and private training courses, as well as training tailored to specific industry needs, and can assist in all aspects of Earned Value Management Implementation.

For more information about EVM training or support, or with questions about your company’s requirements, please contact the Humphreys & Associates corporate office.





7 Principles of Earned Value Management Tier 2 System Implementation | EVM Analysis Read Post »

Earned Value Management for Biotech and Pharma – Part 2 Accounting

By Ric Brock – Engagement Director, Humphreys & Associates

As a follow up to our article on the Earned Value Management for Biotech and Pharma Industries, this is a quick look at how Biotech and Pharma companies collect and manage costs compared to accounting requirements on federal acquisitions.

The Operating Model for the Biotech and Pharma Industry

The basis of the Biotech and Pharmaceutical operating model is to discover/invent a compound or device to meet a need, validate its safety and efficacy, ensure proper patent protection, market it as quickly as possible, and maximize commercialization while there is still patent protection.  In short, it is about speed to market and maximizing the commercial life cycle.

Operating costs are collected and managed from a process costing basis.  Internal costs are usually not collected by a cost objective, as they are not managed to that level of detail.  Most internal labor is collected by department total headcount and labor dollars.  Project or activity based timekeeping is not practiced; i.e. time cards are not used.  External costs (materials, contract services, subcontractors, etc.) are collected within the purchasing system and can be tied to specific activities and traced to the originating departments.  Most companies do have the ability to set up and track job costs within their capital management system.

Federal Acquisition Regulations (FAR), Cost Accounting Standards (CAS), and Timekeeping

The ability to plan and collect actual costs in a consistent and systematic manner by contract/project is a key to the Earned Value Management System requirement.  The costing of items and services purchased by the US Government on a non-firm fixed price basis are covered in the Federal Acquisition Regulations (FAR) and the Cost Accounting Standards (CAS).  The ability to collect costs in a consistent and timely manner is an EVMS prerequisite.

Federal Acquisition Regulations

Federal Acquisition Regulations (FAR) are a set of regulations governing the US Government processes of purchasing goods and services.  Among the guiding principles are to have an acquisition system that satisfies the customer’s needs in terms of cost, quality, and timeliness; to conduct business with integrity, fairness, and openness; and to fulfill other public policy objectives.

Part 52 of the FAR contains standard contract clauses and solicitation provisions. Many clauses incorporate parts of the FAR into government contracts by reference, thereby imposing FAR rules on contractors.

Part 30 of the FAR describes policies and procedures for applying the Cost Accounting Standards Board (CASB) rules and regulations [48 CFR Chapter 99 (FAR Appendix)] to negotiated contracts and subcontracts. This part does not apply to sealed bid contracts or to any contract with a small business concern [see 48 CFR 9903.201-1(b) (FAR Appendix) for these and other exemptions].  Part 30 also identifies the standard contract clauses and solicitation provisions contained in FAR Part 52 that are to be incorporated when applying the CASB rules and regulations to a contract or subcontract.

When a government agency issues a contract or request for proposal, it will specify a list of FAR clauses that will apply.  In order to be awarded the contract, a bidder must either comply with the clauses, demonstrate that it will be able to comply at time of award, and/or claim an exemption from them.  A bidder must also ensure that it understands the contractual commitments, as complying with some FAR clauses may require changes to operating processes.

Cost Accounting Standards

Cost Accounting Standards (CAS) are a set of 19 standards and rules (CAS 401 – 420) that the US Government uses in determining the costs on negotiated procurements.

A company may be subject to full CAS coverage (required to follow all 19 standards), modified CAS coverage (required to follow only Standards 401, 402, 405, and 406), or be exempt from coverage.

Full coverage applies only when a company receives either one CAS-covered contract of $50 million or more, or a number of smaller CAS covered contracts totaling $50 million. In addition to complying with the standards, the company must also file a CAS Disclosure Statement (CASB DS-1) which clearly describes the company’s accounting practices (such as what costs are treated as direct contract charges and what costs are treated as part of an overhead expense). There are two versions of the CAS Disclosure Statement: DS-1 applies to commercial companies while DS-2 applies to educational institutions.

Modified coverage applies when a company receives a single contract of $7.5 million or more.

Timekeeping

Despite the significant role timekeeping plays in government contracting, the FAR provides little direction on timekeeping.  This lack of guidance has been left to government audit agencies (such as the Defense Contract Audit Agency (DCAA) to establish audit standards.  The DCAA uses its Contract Audit Manual (CAM) to provide audit guidance to its auditors.  The CAM provides guidance on auditing timekeeping procedures in section 5-909.  The audit manual states that timekeeping procedures should be able to “assure that labor hours are accurately recorded and that any corrections to timekeeping records are documented…”.

This timekeeping system should feed a labor distribution system that maintains labor hours and dollars by employee, by project/contract, and type of effort account.  This labor distribution should be reconciled to the general ledger labor accounts at least monthly.

Timekeeping is critical.  Unlike other contract costs, labor charges are not supported by external documentation.  The move by a Biotech/Pharma company to a formal timekeeping system may require extensive cultural change.

Summary

As Biotech and Pharmaceutical companies move to FAR contracting, it will require a transition to a project/job costing basis from a process costing basis.  This change may appear straight forward, but any process change requires sound change management.

All aspects of EVMS are critical to ensure the utility of an effective program management tool.  In this blog we provided a summary level look at cost accounting data.  The ability to collect valid, timely, and auditable cost is the foundation for the Actual Cost of Work Performed (ACWP).  Without knowing what we accomplished and what we spent to get to where we are, it is very hard to predict where we are going: the Estimate to Complete (ETC).   As a company designs and develops its EVMS, it must make sure actual cost collection and management is also addressed within the FAR and CAS requirements.

For questions or inquires on how to implement Earn Value project management in the biotechnology or pharmaceutical industries, contact one of the experts at Humphreys & Associates.

Ric Brock - Engagement Director, Humphreys & AssociatesMr. Brock has over 30 years of experience in program and project management, operations, and quality assurance in government and commercial environments.  He has extensive experience working with all levels of an organization, from top management to performing personnel. Ric has extensive experience supporting Pharmaceutical companies in life cycle management, filing new drug applications, and launching new drugs.  He has a wealth of experience with EVM systems across a variety of industries from defense to commercial including biotech/pharma. You can find Ric on LinkedIn



Earned Value Management for Biotech and Pharma – Part 2 Accounting Read Post »

EVM for Biotech and Pharma – Part I Implementation and Training

, , , , , , , , , , , , ,

Updated December 13, 2017



EVM for Biotech and PharmaAs you know, the Earned Value Management System (EVMS) is a management process with characteristics that are absolutely logical to manage projects whether there is an external customer or not. The EVMS is also required by the Federal Government on DOD, DOE, FAA, NSA, DOT, DOJ, NASA, etc. contracts over $20M.

With the phasing in of the Affordable Health Care Act and recent funding for research and preparation in the event of bio-terrorism, other branches of the Government, such as Health and Human Services (HHS) and Biomedical Advanced Research and Development Authority (BARDA), are becoming more involved in the healthcare sector. Implementing and using EVMS is a baseline requirement for biotech and pharmaceutical firms awarded large contracts by the Federal Government.

This will require companies and universities that receive funding to understand and implement Earned Value Management and that key project personnel, including management and executives, will require high quality Earned Value Training.

Why EVM and Government Contracts

Earned Value Management has been used since the 1960’s and has become the standard by which the Government measures and evaluates the management and reporting processes on projects awarded to contractors. Initially, it was implemented on projects; such as the development of satellites, long-range missiles, fighter aircraft, etc., but has become the US Government’s gold standard to manage the technical, schedule and cost progress of projects and to identify and manage risk and opportunities.

In order for defense contractors to be eligible for large contracts, they are required to follow the 32 Guidelines of the EIA-748-C which can entail system design and development and a substantial learning curve. Earned Value Management company-wide training and proper implementation becomes critical for project efficiency, future funding and to meet Government requirements.

Integral to EVM are the uses of the Integrated Master Plan (IMP)/Integrated Master Schedule (IMS) and risk and opportunity management.  The Integrated Master Schedule is the basis for developing the Performance Measurement Baseline (PMB) which in turn, is the basis for measuring performance on a project.   Measurement of progress against the baseline provides early identification of problems and helps to identify and mitigate costs and risks, while also identifying opportunities, by implementation of appropriate corrective actions.

Earned Value Management Systems for Project Management

The basic concept of the Earned Value Management System is more than a unique project management technique.  The EIA-748-C contains 32 Guidelines that define a set of requirements that a contractor’s management system must meet. The objectives of an EVMS are:

  •  Relate time phased budgets to specific contract tasks and/or statements of work
  • Relate technical, schedule and cost performance information
  • Furnish valid, timely and auditable data/information for proactive management action and decision making
  • Provide the basis to capture work progress assessments against the baseline plan to facilitate realistic project costs and completion dates
  • Supply managers with a practical level of summarization for effective decision making

Once a contractor’s EVM System is designed and implemented, there are significant benefits to the contractor and to the customer:

  • Contractor benefits include increased visibility and control to quickly and proactively respond to issues which makes it easier to meet project technical, schedule, and cost objectives
  • Customer benefits include confidence in the contractor’s ability to manage the project, early problem identification, and objective rather than subjective contract cost and schedule status

Earned Value Management Training

Experienced project managers will tell you that understanding the scope, schedule and costs of a project is essential to its success. The primary objective of the EVMS is to ensure that all elements of a project are planned, authorized, managed, and controlled in a consistent and cost-effective manner.  There is an increasing demand for training for organizations beyond the traditional aerospace and defense related construction, software, research and development, and production environment to now include non-defense companies to implement and use the Earned Value Management System.

EVM for Biotech and Pharma

Biotech and Pharma companies are not strangers to dealing with government regulations and requirements. Most have gone through rigorous Food and Drug Administration (FDA) processes to receive approval of compounds and/or devices. Nonetheless, learning how to design and use an EVM system can take a considerable investment of time and money, but is an essential requirement for initial and ongoing funding.

In addition to the EIA-748-C, there are numerous documents that give direction regarding the implementation and use of an EVM system.  Some of these are the National Defense Industrial Association (NDIA) Integrated Program Management Division (IPMD) EIA-748 Intent Guide, Cost Accounting Standards (CAS), Data Item Descriptions (DID), Military Standards (MIL-STD) such as MIL-STD-881, the Earned Value Management System Interpretation Guide (EVMSIG), and many others.  We have helped many organizations to ensure that they do not overkill or underkill based on their desired management system characteristics.  H&A personnel understand the requirements and are able to “size” those requirements to meet company and customer requirements.

Although Biotech and Pharma are relatively recent industries to use EVM, Humphreys & Associates (H&A) has been providing Earned Value Management training and implementation services for over 35 years. H&A provides self-paced online, classroom and private training courses, and can assist in all aspects of Earned Value Management Implementation.

For more information about EVM training or support, or with questions about your company’s requirements, please contact the Humphreys & Associates corporate office.

EVM for Biotech and Pharma – Part I Implementation and Training Read Post »
